Volume 9, Sudan Part 5: Gebel Barkal and Nuri, 1919, page 34

Item

Title
Volume 9, Sudan Part 5: Gebel Barkal and Nuri, 1919, page 34
Author
Description

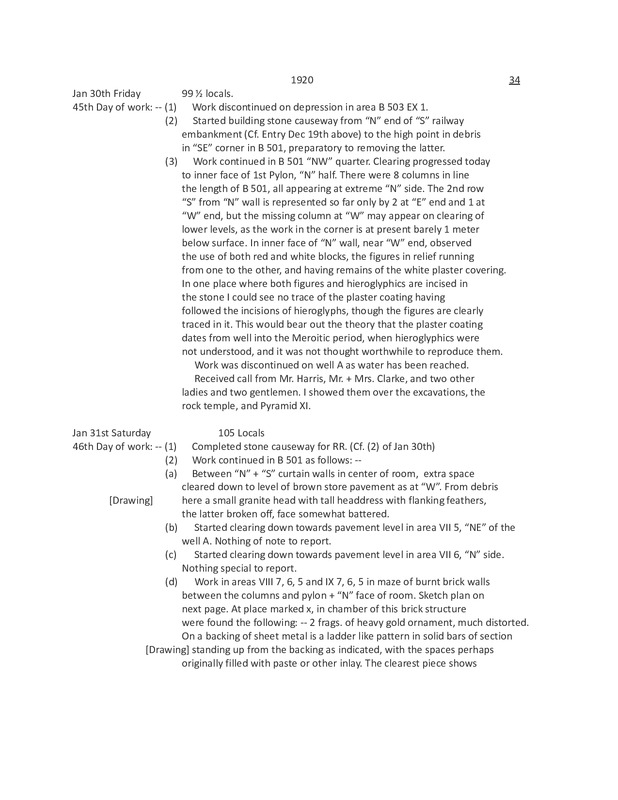

Discontinued work on pit in B 503 EX 1. Started building a stone causeway from "S" railway embankment to debris in "SE" corner of B 501. Work continued in "NW" quarter of B 501, with discussion in notes. Work discontinued on well A. Dunham showed Mr. Harris, Mr. and Mrs. Clarke, and others around the site. Completed stone causeway. Began clearing in areas of B 501, Railway; Mr. Harris; Mr. Clark; Mrs. Clark;
Relation
Railway; Mr. Harris; Mr. Clark; Mrs. Clark; Pyramid XI; B 503 EX 1; B 501; VII 5; VII 6; VIII 7; VIII 6; VIII 5; IX 7; IX 6; IX 5;
